Within  the  scope  of  the  project  with  a  total  contract  values  of
                                                                        $454.543.319 as per 2010 unit prices, earth works, minor and large
                                                                        structures (6 viaducts with a total length of 4.436 m.), pavement
                                                                        works (wetmix and hotmix), geotechnical works, landscaping, toll
                                                                        collection and secondary works (utility works, service and parking
                                                                        areas, maintenance centers) are constructed. Traªc signs, road
                                                                        marking, guardrail and Row fence constructions are excluded and
                                                                        have  been  contracted  out  by  NÖMAYG  separately.  Coordination
                                                                        and supervision of the construction works of those items will be
                                                                        on responsibility of NUROL.

                                                                        By the end of 2017 project goals has been mostly accomplished. Works
                                                                        on minor and large structures, earthworks, viaducts, prestressed
                                                                        beams drainage, pavements are proceeding on all sections as of

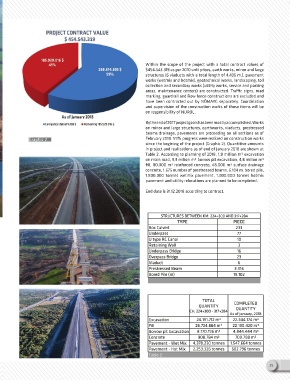

                   Graphic 2                                            February 2018. 59% progress were realized on construction works
                                                                        since the begining of the project (Graphic 2). Quantitive amounts
                                                                        in project and realizations as of end of January 2018 are shown at
                                                                        Table 2. According to planning of 2018, 1,9 million m³ excavation
                                                                        on main road, 3,3 milion m³ borrow pit excavation, 4,6 milion m³
                                                                        fill, 80.000 m³ reinforced concrete, 48.000 m³ surface drainage
 Gebze - Orhangazi - İzmir                                              concrete, 1.675 number of prestressed beams, 6.104 m. bored pile,
                                                                        1.800.000  tonnes  wetmix  pavement,  1.000.000  tonnes  hotmix
                                                                        pavement and utility relocations are planned to be completed.

 Motorway Construction                                                  End date is 31.12.2018 according to contract.
