towards north due  to the fact that it was  especially in mega projects that require  How many vehicle passages are guaranteed
              located on slope in the sea and located on a  very large amounts of investments such as  daily according to Highway data? What will
              horizontal soil at a depth of -40 meters. As  our Projects, to make up the deficit from  happen when this number is not reached?
              a result of these inevitable displacements  the budget until the income obtained from
              in the north direction, the main span of the  the users reaches the guaranteed income
              bridge was shortened from 1700 meters to  level is a rule which is applied not only in
              1550 meters. For this reason, it became the  Turkey but in the whole world. Guaranteed
               th
              4  longest suspension bridge of the world.  traffic  numbers  and  vehicle  passage fees
                                                     were  determined  by  Highways  General
              When did you begin to earn income from  Directorate (KGM) at the time of the tender  Pursuant to the contract, if the toll booth
              the project and at which section? What is  and were included in the Implementation  income corresponding to these figures is not
              the truth under the statement of “everyone  Contracts signed by and between the  reached at the evaluation to be made at the
              will pay, whether he passes or not” about  Administration and our Assigned Company.  end of the year, the difference will be put
              the income that was publicized in the  This consideration asserts the argument  into the budget of the next year by KGM and
              press? Would you make some explanation  that all investments made from the state  paid by KGM to the Assigned Company.
              about the fee charging?                budget are investments paid by those who
                                                     “do not pass/use” them. Fare charges were  When the bridge is commissioned, how

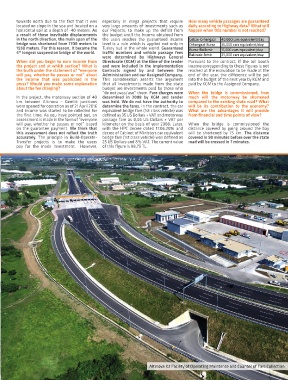

              In the project, the motorway section of 40  determined in 2008 by KGM and tender  much will the motorway be shortened
              km between Altınova – Gemlik junctions  was held. We do not have the authority to  compared to the existing state road? What
              were opened for operation as of 21 April 2016  determine the fares. In the contract, the car  will be its contribution to the economy?
              and income was started to be collected for  equivalent bridge fare (1st class vehicle) was  What are the advantages it will provide
              the first time. As you have pointed out, an  defined as 35 US Dollars + VAT and motorway  from financial and time points of view?
              assessment is made in the form of “everyone  passage fare as 0,05 US Dollars + VAT per
              will pay, whether he passes or not” based  kilometer on the basis of year 2008. Later,  When the bridge is commissioned the
              on  the  guarantee  payment.  We think that  with the HPC decree dated 17.06.2016 and  distance covered by going around the bay
              this assessment does not reflect the truth  decree of Cabinet of Ministers car equivalent  will  be  shortened  by 75  km.  The distance
              accurately. The principle in Build-Operate-  bridge fare (1st class vehicle) was defined as  covered in 90 minutes before over the state
              Transfer projects is to make the users  25 US Dollars and 8% VAT. The current value  road will be crossed in 7 minutes.
              pay  for  the  made  investment.    However,  of this figure is 88,75 TL.
