Page 43 - Engilish 2015 Annual Report
P. 43

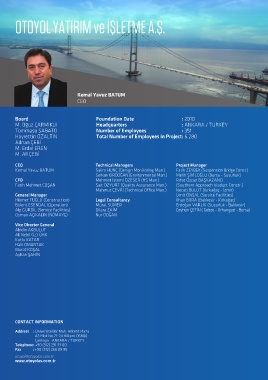

OTOYOL YATIRIM ve İŞLETME A.Ş.                                                                                                ackground;                                       completed by signing the  finance documents on June


                                                                                                                                      the  tender  for  Motorway  Project  for  Gebze  -   05,2015. Thus, the funding required for the entire project in
                                                                                                                               BOrhangazi - Izmir (including İzmit bay crossing and    the form of refinanced loan of 2 billion USD for Phase I and
                                                                                                                                Connection Roads) was conducted on 9 April 2009 and the   Phase II A as well as funding required for Phase II B have
                                                                                                                                proposal submitted by Nurol - Özaltın -Makyol - Astaldi -   been secured with a new loan package amounting to 4.956
                                                                                                                                Yüksel - Göçay Group was selected as to be the best    billion USD. As of the end of March 2016, approximately 3,84
                                                                                                                                proposal with 22 years and 4 months construction and   billion USD has been spent towards project costs, divided as
                                                                                                                                operating period.                                      follows: Phase I 2,65 billion USD, Phase II A 410 million  USD
                                                                                                                                                                                       and Phase II B 780 million USD.
                                                                                                                                OTOYOL YATIRIM  VE İŞLETME  A.Ş. was founded on 20
                                   Kemal Yavuz BATUM                                                                            September 2010 with the contribution of the companies   Turkish Leadres;
                                   CEO                                                                                          (Nurol - Özaltın -Makyol - Astaldi - Yüksel - Göçay) to perform
                                                                                                                                the works of construction, operation and transfer of Gebze -   Akbank, Finansbank, Ziraat Bankası, Garanti Bankası, Halk
                                                                                                                                Orhangazi – Izmir (including İzmit bay crossing and    Bankası, İş Bankası, Vakıflar Bankası, Yapı ve Kredi bankası.
        Board                               Foundation Date                           : 2010                                    Connection Roads) Motorway  Project through Build -
        M. Oğuz ÇARMIKLI                    Headquarters                              : ANKARA / TURKEY                                                                                Foreign Leadres;
        Tommaso SABATO                      Number of Employees                     : 351                                       Operate - Transfer model.
        Hayrettin ÖZALTIN                   Total Number of Employees in Project: 6.280                                         The project implementation agreement was signed        Deutsche Bank, Saudi National Commercial Bank, Bank of
        Adnan ÇEBİ                                                                                                                                                                     China, Siemens Bank.
        M. Erdal EREN                                                                                                           between the General Directorate of highways and OTOYOL
        M. Ali ÇEBİ                                                                                                             YATIRIM VE İŞLETME A.Ş. on 27 September 2010.          Project and Route

        CEO                                 Technical Managers                 Project Manager                                  The ceremony go start of construction works in Gebze for   As this new project will shorten the route about 140 km when
        Kemal Yavuz BATUM                   Salim HUNÇ (Design Monitoring Man.)  Fatih ZEYBEK (Suspension Bridge Const.)        Gebze - Orhangazi - Izmir Motorway Project took place on   compared to the current state highway, the travel time
                                            Serkan KIRDOĞAN (Environmental Man.)  Melih ŞİVİLOĞLU (Bursa - Susurluk)            28 October 2010 in Dilovasi district of Kocaeli Province and   corresponding to 8-10 hours will be shortened to 3,5 - 4
        CFO                                 Mehmet İstemi ÖZESER (HS Man.)     Rıfat Özcan BAŞKAZANCI
        Fatih Mehmet COŞAN                  Sait ÖZYURT (Quality Assurance Man.)  (Southern Approach Viaduct Constr.)           Ceremony for start of construction works in İzmir was held   hours, which will provide  TL 870 million saving a year in turn.
                                            Mahmut ÇEVRİ (Technical Office Man.)  Necati BULUT (Kırkağaç - İzmir)               in Alsancak Cumhuriyet Square on 27 February 2011.
        General Manager                                                        Ümit ÖNSAL (Service Facilities)                                                                         The starting point of the project is Gebze and the Motorway
        Hikmet TUĞLU (Construction)         Legal Consultancy                  İlhan BORA (Balıkesir - Kırkağaç)                İstanbul - Bursa - İzmir  Motorway, Intersections between   will cross İzmit bay located between Dilovası and Hersek
        Bülent ESENDAL (Operation)          Murat SÜMER                        Erdoğan VARLIK (Susurluk - Balıkesir)
        Alp GÜRDİL (Service Facilities)     Dilara ZAİM                        Ceyhun ÇETİN ( Gebze - Orhangazi - Bursa)        Gebze and Gemlik (including Osmangazi Suspension       through a Suspended Bridge of about 3.000 meters
        Osman AÇIKALIN (NÖMAYG)             Nur DOĞAN                                                                           Bridge) has been opened to traffic on July 1, 2016.    length, then will extend to Orhangazi and Gemlik and be
                                                                                                                                                                                       connected to Bursa Ring Road at Ovaakça intersection.
        Vice Director General                                                                                                   Otoyol  Yatırım ve İşletme A.Ş.
        Abidin AKBULUT
        Ali Nebil ÖZTÜRK                                                                                                        Procured services such as gulf soil surveys, motorway   Following the Bursa Ring Road which is already
        Kutlu KATAR                                                                                                                                                                    operational, the Motorway reaches Balıkesir starting with
        Halil OMURTAK                                                                                                           route soil surveys, signature of Motorway and Suspended   Bursa - Karacabey intersection and continuing through
        Murat KOŞAL                                                                                                             Bridge construction contract and design works, legal
        Ayhan ŞAHİN                                                                                                             infrastructure studies and project consultancy services for   the north of Susurluk. It continues south from the west of
                                                                                                                                the motorway project and performed activities required   Balıkesir, ahead  via Savaştepe, Soma, Kırkağaç districts
                                                                                                                                for preliminary preparation activities in physical aspects  and continues towards the west near Turgutlu. It moves
                                                                                                                                and project financing.                                 along  paralel to İzmir - Uşak state highway  and finally
                                                                                                                                                                                       connects with Anadolu Lisesi intersection over the İzmir
                                                                                                                                The Project financing for Phase I (from Gebze to Gemlik   ring road.
                                                                                                                                Intersection including the Osmangazi Suspension Bridge)
                                                                                                                                and Phase II  A (from Gemlik Intersection to Bursa     The project has a total length of 433 km including
                                                                                                                                Intersection)  were completed in the first quarter of 2013   a highway length of 384 km and an access road length of
                                                                                                                                and in the second quarter of 2014, respectively. 2,0 billion   49 km. Along the route, there are 38 viaducts with a total
        CONTACT INFORMATION                                                                                                     USD loan was secured via a 1,4 billion USD equity      length of 21.547 m, including the Osmangazi Suspension
                                                                                                                                commitment by shareholders.                            Bridge and the Northern/ Southern  Approach Viaducts,
        Address     : Üniversiteliler Mah. Bilkent Plaza                                                                                                                               3 tunnels with a total length of 6.380 m, 169 bridges, 20 toll
                     A3 Blok No:21-24 Bilkent 06800                                                                             The process of refinancing this debt to extend the maturity
                     Çankaya - ANKARA / TURKEY                                                                                                                                         collection areas, 25 intersections, 4 Highways and 2 Tunnel
        Telephone: +90 (312) 291 33 00                                                                                          and secure required additional funding of 3,0 billion USD   Maintenance-Operation  Centres,  as  well  as  35  Service
        Fax        : +90 (312) 266 09 95
                                                                                                                                for Phase II B (from Bursa Intersection to İzmir) was
        otoyol@otoyolas.com.tr                                                                                                                                                         Stations and Parking Areas.
        www.otoyolas.com.tr
